Skip to content Skip to left sidebar Skip to right sidebar Skip to footer

Author: Chantel Edwards

George Launches New High-Tech Street Sweeper Truck to Boost Clean City Drive

In the photo: The new mechanical street sweeper truck launched at the Civil Engineering Depot. In the photograph from left to right are Cllr Jean Safers, Cllr Monique Simmers, Cllr Teresa Jeyi, Executive Mayor Jackie von Brandis, MMC Civil Engineering Services Marchell Kleynhans, Deputy Director Streets and Stormwater Lionel Daniels. Sharing in the excitement are far right the supplier of the vehicle, Dealer Principal for Shorts Nissan Grant Flattery and Managing Director for Transtech who manufactured the specialised vehicle, Chris-Henri Munro.

Video Link: https://youtu.be/R1Q_uNoV4lA?si=bqrkZfvLo72a3Q8e

George Municipality has officially launched its brand-new mechanical street sweeper truck, a powerful addition to the city’s road maintenance arsenal. The high-tech vehicle was unveiled at the Civil Engineering Services Depot this week and will begin regular cleaning operations across George immediately.

“During June 2025 a rented machine was used for a trial run and approximately 137km of road was cleaned, which equates to approximated 275km of roadside. This R4.5 million investment marks a major milestone in the city’s commitment to cleaner, safer streets and improved stormwater management.” said Executive Mayor Jackie von Brandis.

“With this acquisition, George becomes the only municipality in the Garden Route to operate mechanical street sweepers,” said Lionel Daniels, Deputy Director for Streets and Storm Water. “This innovative vehicle enhances our ability to keep our urban areas clean, reduce flood risk, and protect our natural watercourses from pollution.”

The sweeper truck is equipped with brooms on either side, a central sweeper under the chassis, a front-mounted sprayer to reduce dust, and internal suction that collects debris like leaves, gravel, and dirt into a large internal bin. Fine dust is then filtered and released through a rooftop vent. The vehicle can also spray herbicide along road edges to manage weed growth.

Ahead of the official launch, the municipality rented a similar sweeper truck to pilot operations in areas like Loerie Park, Denver Park, Bergsig, Levallia, Protea Park, and parts of George Industria. This trial period allowed teams to fine-tune logistics, determine production rates, and develop the right staff composition. A dedicated team is deployed on foot ahead of the truck to manually loosen compacted dirt, remove larger debris like rocks and tree branches, ensuring maximum cleaning effectiveness. The goal is to establish a regular cleaning schedule across George, rotating through several wards at a time for city-wide coverage.

Four drivers from Civil Engineering Services have already begun specialised training to operate the vehicle. Plans are also underway to rent a second street sweeper in the near future, with the long-term goal of owning two municipal sweepers working simultaneously to improve coverage and efficiency. Recent cleaning projects where manual labour was used, indicated that cleaning can cost approximately R1 million per Ward, making this mechanised solution both cost-effective and impactful.

“This street sweeper is more than just a vehicle—it’s a long-term investment in public health, environmental sustainability, and civic pride,” Daniels added. George Municipality thanks the public for its continued support and cooperation as we roll out this exciting new initiative to help keep George clean, green, and growing.

PUBLIC NOTICE: REMEDIAL ROADWORKS: EAST STREET, PACALTSDORP (02 – 03 JULY 2025)

George Municipality is currently undertaking periodic maintenance in half road widths on East Street, Pacaltsdorp, which serves as a detour route
as part of all the road upgrades currently underway in Pacaltdorp. Over the past few months this road has deteriorated rapidly, thus remedial maintenance of the road is required.

How will it affect road users:
– Motorists heading into Pacaltsdorp will still be able to travel the normal route via North and River Street
– Motorists heading out of Pacaltsdorp will temporarily need to make a left turn out of River Street, into East Street, then right into Fountain Street, tight into Polar Avenue and continue to East Street to follow their normal route

Completion of the Works is expected on 03 July 2025 (weather permitting).

PUBLIC NOTICE – Possible Pollution Gwaing River

Issued George Municipality, 2 July @ 14:33

George Municipality is aware of possible sewage pollution from a private institution into the Gwaing River Mouth.

Our Scientific Services Department is currently conducting sampling to determine the E-Coli levels in the River.

We request the Public to avoid using the Gwaing River Mouth for swimming or fishing until further notice.

MAJOR ROAD AND INFRASTRUCTURE UPGRADES UNDERWAY ACROSS GEORGE

Jonga / Nelson Mandela Boulevard Transfer Location

George Municipality is currently implementing large-scale road and infrastructure upgrades across the city to support the expansion of the GO GEORGE public transport service. These upgrades form part of a multi-year capital investment enabled through funding received from the Public Transport Network Grant (PTNG) administered by the National Department of Transport.

An addition R250 million has been awarded for new projects to be implemented during the 2025/26 financial year. In the 2024/25 financial year R505 million has also been allocated towards the rollout of essential public transport infrastructure. These funding supports road rehabilitation, construction of transfer locations (TLs), sidewalk upgrades to promote universal accessibility, and other associated infrastructure improvements.

Speaking during an Eden FM radio broadcast on 30 June 2025, MMC for Civil Engineering Services, Cllr Marchell Kleynhans, and Deputy Director for Roads and Stormwater, Lionel Daniels, explained that the scope and pace of current roadworks are a direct result of this funding windfall. “Our original plan was to phase projects over three years, but we received the entire amount in one go,” said Daniels. “This came with conditions—including that the funding must be spent within a specified timeframe. That is why several major routes in areas such as Pacaltsdorp are being upgraded simultaneously.”

“This is one of the largest infrastructure rollouts in George’s history,” says Cllr Marchell Kleynhans, MMC for Civil Engineering Services. “While the temporary disruption is unavoidable, the long-term impact will be safer roads, better accessibility, and improved commuting efficiency for all road users.”

ROAD REHABILITATION PROJECTS – PROGRESS UPDATE
George Municipality is committed to providing regular updates to the public on the progress of road upgrades across the city.

PACALTSDORP
• Mission Street: 39% complete | Commenced 18 October 2024 | Expected completion: June 2026
• Protea Street: 83% complete | Commenced 30 September 2024 | Expected completion: September 2025
• Heather, Haydn and Rose Streets: 28% complete | Commenced 25 September 2024 | Expected completion: July 2026

THEMBALETHU
• Ngcakani and Ncamanza Streets: 61% complete | Commenced 21 October 2024 | Expected completion: January 2026
• Tabata and 26th Streets: 61% complete | Commenced 25 September 2024 | Expected completion: March 2026

GEORGE INDUSTRIA
• PW Botha Boulevard: 35% complete | Commenced 26 September 2024 | Expected completion: July 2026

ROSEMOOR
• Beer and Woltemade Streets: 79% complete | Commenced 13 August 2024 | Expected completion: July 2025
• O’Connell Street: 81% complete | Commenced 19 August 2024 | Expected completion: July 2025

HEATHER PARK
• Airway Street: Construction complete | Practical completion achieved in March 2025 | Final Road markings completed June 2025

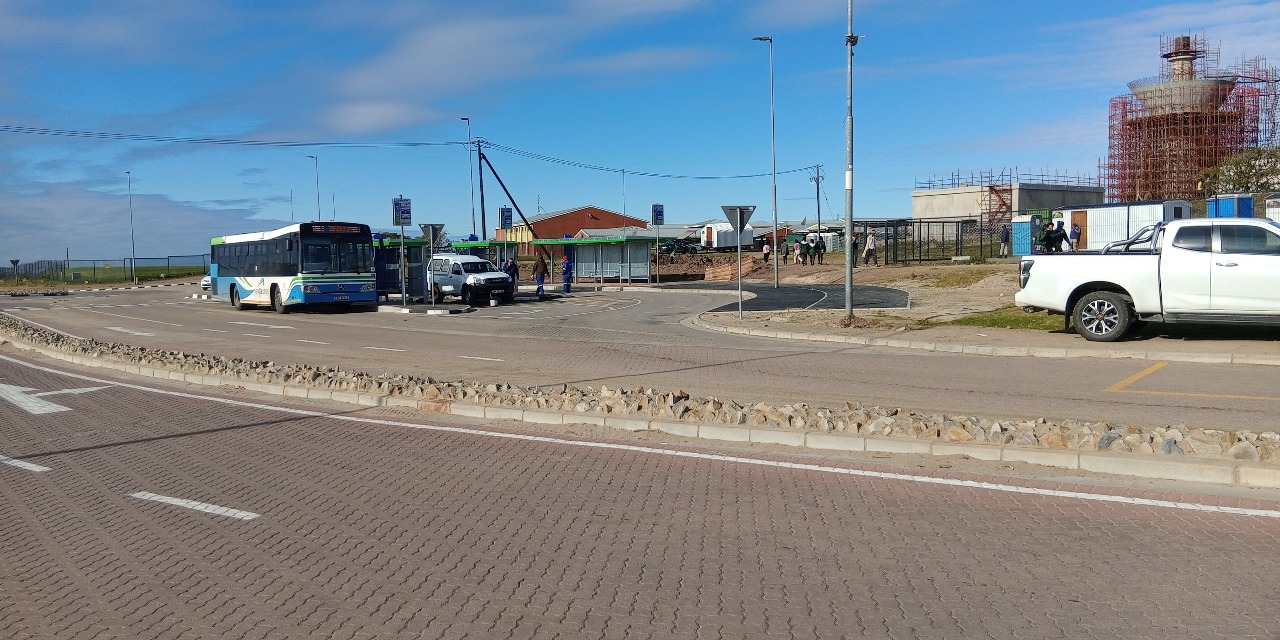

Ncamanza / Nelson Mandela Boulevard Transfer Location

TRANSFER LOCATIONS – CRITICAL SUPPORT INFRASTRUCTURE FOR GO GEORGE
In addition to road upgrades, the construction of GO GEORGE Transfer Locations (TLs) is progressing. These facilities are essential for improving route connectivity and allowing commuters to transfer safely and efficiently between routes.

Current Projects:
• Beach/Panther TL: 65% complete | Commenced March 2025 | Expected completion: July 2025

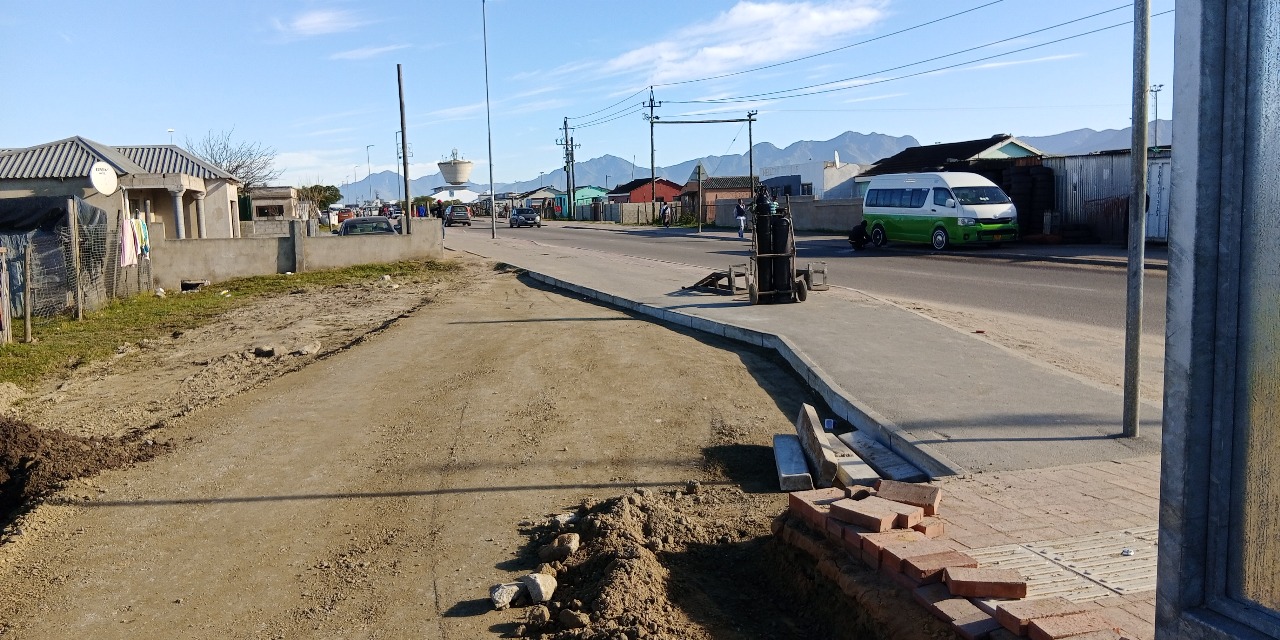

• NMB/Jonga Intersection TL: 70% complete | Commenced February 2025 | Progress dependent on associated infrastructure
• 26/Ncamanza/NMB TL: Construction commenced in May 2025 | Expected completion: August 2025 (subject to bridging finance)

“In addition to the long-term benefits—like safer roads and improved accessibility—we’re also proud that these projects are creating jobs and empowering emerging contractors, especially from areas like Pacaltsdorp,” said Kleynhans. “The temporary inconvenience is unfortunate but necessary for lasting development.”

PLANNED INFRASTRUCTURE PROJECTS – 2025/26 FINANCIAL YEAR
With the recent allocation of R250 million, George Municipality will commence with the following infrastructure projects in the new financial year:
Construction on these projects is expected to begin within the next 2–3 months, with most scheduled for completion within 5–9 months.

Planned Road Upgrades:
• Beukes Street (Geelhout to Beach Road)
• Cradock Street (Hibernia to Market Street)
• Pine Street (Witfontein to Protea Street)
• Plattner Street (Airway to Victor Smith Street)
• Protea Street (Phase 3 and 4)
• Beer Street (Phase 3)
• Tabata Street (26th to Lingelethu Street)
• Genesis Street

Planned Transfer Locations and Associated Sidewalks:
• Cradock Street CBD (Transport Hub Phase 2)
• Main / School Terminus
• Protea Precinct
• York Street (Market to Hibernia)
• Courtenay / Wellington Intersection
• NMB / Vuyani Ncamazana / Main Intersection
• York / Union Intersection
• Thembalethu Roundabout (Jonga Phases 2 and 3)

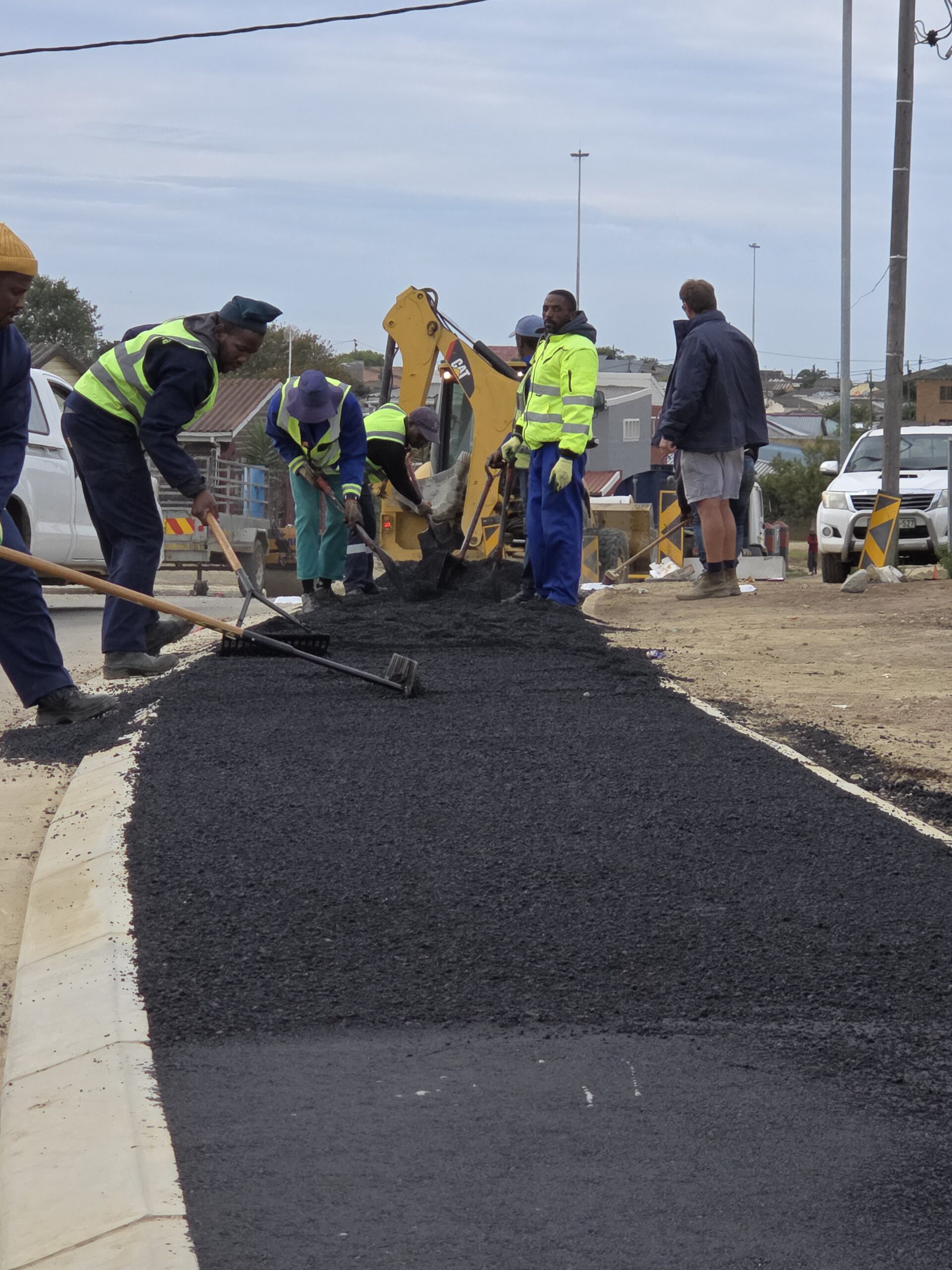

Ngcakani Street Phase 3 Sidewalk Construction

PUBLIC TRANSPORT DELAYS AND EMPLOYER COMMUNICATION
George Municipality acknowledges the impact of ongoing construction on bus operations and general traffic flow, particularly in Pacaltsdorp and surrounding areas. GO GEORGE is continuously monitoring the situation and implementing mitigation measures including temporary route changes and the deployment of additional buses where possible.

“We continue to receive numerous complaints from commuters whose travel times have been affected, and we appeal to employers to show understanding where lateness is due to factors beyond the commuter’s control,” said Kleynhans. “The first few buses in the mornings are often already full, and once they are caught in outbound peak traffic, the ripple effects can delay multiple routes.” Employers who require confirmation of service delays are encouraged to contact the GO GEORGE Call Centre. Trip slips showing boarding times are also available for verification purposes.

George Municipality remains committed to improving the quality and safety of its transport infrastructure. These upgrades are essential to the city’s development as a smart, integrated and accessible urban centre. Road users are reminded to exercise caution near construction zones, adhere to all temporary signage and plan their travel to accommodate possible delays. Regular updates will continue to be published via the Municipality’s official communication channels.

Urgent Public Notice: Upgrading Of Eden Sewage Pumpstation – Weekend Work/Public Holiday

The planned construction activity of the UPGRADING OF EDEN SEWAGE PUMP STATION, initially scheduled to take place on weekdays, will also include work on the weekends of:

  • Saturday 5th July 2025
  • Saturday 12th July 2025
  • Saturday 19th July 2025
  • Saturday 26th July 2025

Working hours on Saturdays will be from 07:00 to 14:00. The construction activities extend from the Eden Sewage Pump station to Dikkop Str and Pikkewyn Str.

SERVICE DISRUPTION:
Minor operational interruptions can be expected during the construction works. Advance notifications of planned temporary disruptions and the effects thereof will be issued via social media.

TRAFFIC IMPACT:
Residents, road users, and pedestrians are advised to exercise caution during the construction period. Please adhere to flag persons, temporary construction works and road signage.

ACCESS TO SITE:
Access to the construction site will be strictly controlled. In accordance with the Occupational Health and Safety Act, no members of the public will be allowed in the construction area.

PROJECT ENQUIRIES   : Mr Kosie Smit – 044 801 9496 (Technical)
: Ms Shaldene Davids – 074 899 4420 (Community Liaison Officer)

The George Municipality apologises for any inconvenience and appeals to the public to be patient and exercise caution throughout the construction period. Thank you for your understanding and cooperation.

GARDEN ROUTE DAM LEVEL

Percentage storage at new raised dam wall height 90.62%
Rainfall for the previous days: 3.7 mm (Measured from 23 – 30 June 2025)

Please see the link to 2B water restrictions implemented as of 1 May 2024: http://tinyurl.com/3439h4n7
The cooperation of all users of municipal water is essential and is greatly appreciated.

PUBLIC NOTICE: PLANNED WATER OUTAGE – Thembalethu Zone 1 / 7 / 8 / 9

A planned construction activity on the Thembalethu West project will take place on 24 June to 25 June 2025.

SERVICE DISRUPTION:
Minor operational interruptions can be expected during the construction works, and residents may experience low water pressure during this time.

AFFECTED AREAS:

  • Thembalethu Zone 1
  • Thembalethu Zone 7
  • Thembalethu Zone 8
  • Thembalethu Zone 9

PROJECT ENQUIRIES  Mr Andre Scheepers – 044 801 9492 (Technical)  or Mr Alewijn Dippenaar – 082 457 5675 (Public Liaison Officer

The George Municipality apologises for any inconvenience and appeals to the public to be patient and use water sparingly. Thank you for your understanding and cooperation.
